“Sukitha Purawara” Program
The present government initiated to develop western region under the Western Region Megapolis Planning Project, which is to be prepared by covering whole Western Province. The current population in the Western Province is 5.8 million, which accounts for approximately 29% of the county’s population. The GDP contribution of the Western Province is nearly 45% of the county’s total GDP. Therefore over the years the province has attracted many migrant people due to various comparative advantages. This inward migration of people caused to urban expansion/ sprawl of Colombo which has spread beyond its administrative boundaries to both inner and outer suburban areas. As a result of this serious of secondary townships emerged in the spatial structure of the Colombo. The development of these townships have not undergone through a comprehensive planning approach, instead haphazard development was taken place in these townships as per aspirations of individual developers/ investors.With the high population growth in these suburban townships, the demand for required physical, social and environmental infrastructure continuously grew at a higher rate than the supply. This caused major issues in relation to transportation, housing, public recreation facility and city economy in these urban sub systems.
In this background with the guidance and directives of Ministry of Megapolis and Western Development the UDA has initiated the “Sukitha Purawara” Program in order to cope up with the issues which need to be tackled in the short term basis.
The objectives of this program are,
- Improve comfort, convenience of the city users.
- Improve livability of the city.
- Enhance city economy in a way which benefits to the all segments of the community.
- Ease emerging issues in relation to traffic congestion, housing demand, community open spaces and etc.
New projects expected to start in 2016, under the Budget Proposal
No. | Details Description of Project | Total TEC Rs. |
01 |
“Supasan Purawara” Programme (“සුපසන් පුරවර වැඩසටහන”) (Townships included under the programme are, Homagama, Kottawa / Makumbura, Maharagama, Piliyandala, Kaduwela, Battaramulla, Malabe, Borella, Kolonnawa, Hanwella, Avissawella, Panadura, Kalutara, Horana, Bandaragama, Gampaha,Kadawatha, Kiribathgoda, Ja-Ela, Ragama, Kerawalapitiya) |
Approx. Rs. 7.6 Bn |
Current Programs
Sri Lanka Land Reclamation and Development Corporation (SLLR and DC) >
Name of the Project | Progress | Present Status of the Project | Project Issues | ||
Contract Sum (SLR Mn.) | Physical % |
Financial % |
|||
Homagama Bus Stand Development | 79.9 | 5 | 20 | Extra work for canal excavation by removing debris. Has to construct an Access Road | |
Kottawa Bus Stand | 45.9 | 8 | 20 | ||
Maharagama Bus Stand - Phase 01 |
64.5 | 20 | |||
Piliyandala Land Development - Phase 01 |
173.4 | 20 | 20 | Two culverts have to be constructed. | |
Kalutara Commercial Development Between Station & Bus Stand | 113 | 10 | 20 | Delayed due to rate Negotiations | |
Enderamulla Drainage Improvement, Development of Playground | 169.6 | 20 | Site Clearance Recommencement of the project | Flooding | |
Ragama Drainage Improvement - Phase 01 | 14.5 | 20 | Tenders have been called for canal bank improvement and dredging. | ||
Manning Market Relocation (Land Development Contract) | 400 | 80 | 20 | Culverts construction stopped until finalize fill level |
Progress at site
Kottawa Bus Stand
Kalutara Commercial Development Between Station and Bus Stand
Manning Market Relocation Site
State Development and Construction Corporation (SD and CC) >
Name of the Project | Progress | Present Status of the Project | Project Issues | ||
Contract Sum (SLR Mn.) | Physical % |
Financial % |
|||
Land Development Works for Commercial Complex at Battaramulla | 134 | ||||
Borella Multipurpose Hall & Playground | 63.6 | 20 | Contractor mobilized to site | ||
Panadura Galawatta Land Development | 17.5 | 20 | Project hold due to a unauthorized construction at site | ||
Gongithota Community Center | 27.9 | 20 | Site Clearing Works has started | ||
Pavilion and Ground Improvement of Play Ground at Malwathuhiripitiya | 55.4 | Contractor not mobilized to the site | LOA to be issued | ||
Mirigama Completion of Commercial Building | 76.7 | 20 |
Progress at site

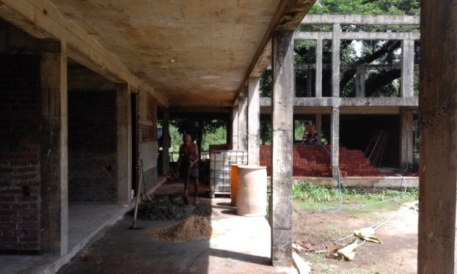

Mirigama Completion of Commercial Building
Provincial Road Development Authority (PRDA-WP) >
Name of the Project | Progress | Present Status of the Project | Project Issues | ||
Contract Sum (SLR Mn.) | Physical % |
Financial % |
|||
Borella Eliot Place Phase I & II | 57.1 41.5 |
15 | 20 | Removal of PSD building in Stage II | |
Improvements at Lesley Ranagala Mawatha | 47.5 | Just mobilize the site | |||
Connection Road to Kithulwatta Road at Boralla | 165.3 | 2 | Removal of toms affects the road trace | ||
Lake Drive to Kirimandala Mawatha Narahenpita | 151.7 | Design to be submitted by RDA within 1 month | |||
Udupila Junction Improvements Works | 48.4 | Bids were submitted | Land acquisition to be done | ||
Welipillawa Junction Improvement | 51.85 | Road Designs completed Bids have been submitted | Land acquisition to be done | ||
AGA Office Junction Improvement at Mahara | 36.8 | ||||
Improvements Works at Indigahamulla Junction | 34.5 | Not mobilized Letter of award not given | |||
Improvements Works at Buthpitiya Junction | 52.2 | Bids have been submitted | |||
Mirigama Public Square Between Railway & Bus Stand | 111.5 | 20 | |||
Mirigama Playground | 62.4 | 20 | |||
Improvements Works at Meerigama Sathi Pola | 96.2 | ||||
Bombuwala Bypass Road | 32.1 |
Progress at site
Borella Eliot Place Phase I and II
State Engineering Corporation (SEC) >
Name of the Project | Progress | Present Status of the Project | Project Issues | ||
Contract Sum (SLR Mn.) | Physical % |
Financial % |
|||
Weekly Pola at Wellampitiya | 87.1 | Site handing over on24.5.216 for tem. Relocation | |||
Panadura Bus Stand | 71.8 | 5 | 20 | Excavation in Bus Stand. Toilet Block not started | |
Proposed Bus Stand (Stage II) - Part 1 at Horana | 51.6 | ||||
Market Complex at Bandaragama Stage 1 | 91.2 | Site handing over, 2016. after tem. Relocation | |||
Design and Construction of Linear Park at Ja-Ela | 73.5 | Tender Awarded | Flood level over 6” in existing boundary wall Design To be change |
Central Engineering Consultancy Bureau (CECB) >
Name of the Project | Progress | Present Status of the Project | Project Issues | ||
Contract Sum (SLR Mn.) | Physical % |
Financial % |
|||
Maharagama Multi Storied Car Park Stage 01 | 162.1 | 20 | |||
Kaduwela Pola Development | 125 | 20 | |||
Kalutara Public Market - Stage 01 | 180.1 | 20 | |||
Administrative Complex - Mahara A Phase 1 | 72 | One portion of land has been cleared. Relocation of existing offices (except Samurdhi Bank) will be relocated before 25th May, 2016. | |||
Commercial Complex at Mahara Stage 1 | 129.7 | ||||
Multi Purpose Building at Malwathuhiripitiya | 44.9 | Awarded. Still not mobilized the site. | Changing of site area. Design changes occurring | ||
Proposed Bus Stand Development at Molawatte | 133.3 | Site has not yet cleared by the RDA | |||
Other Province Projects | |||||
Hatton Town Centre Development | 68 | ||||
Greater Kandy Development | 64.7 | ||||
Nuwara Eliya Commercial Complex - Drainage Improvements | 72.1 | ||||
Haputhale Town Centre Development Works - Viewing Deck | 17.7 | ||||
Ella Town Development Works - Bypass Road | 26.5 | ||||
Tourist Facility Centre at Polonnaruwa | 84.7 |
Progress at site
Proposed Bus Stand Development at Molawatte
